How to Bill a Job in Stages: Draws, Liens, Final Invoice

How to bill a job in stages: a deposit inside your state's cap, draws tied to the quote's lines, lien releases, retainage and what to do about a late draw.

The MakeHay team · · 11 min read

An excavator loads soil into a dump truck on a job site

Here is how to bill a job in stages so the money arrives as the work does: a deposit inside your state's cap, a draw after each milestone that points back to a line on the approved quote, a lien release traded for each payment, and a final invoice for what is left.

When billing in stages fits, and when one invoice is enough

One invoice at the end works for a job that starts and finishes the same day with materials you already carry. Stage billing earns its paperwork when any of these is true:

  • The job runs across more than one trip, so wages go out before the customer's money comes in.
  • You buy materials for this job alone: ready mix by the yard, rebar, a culvert, fill hauled in.
  • Rented equipment sits on your card until the invoice is paid.
  • The customer's lender or a general contractor releases money by stage.
  • One unpaid invoice would decide whether you make payroll.

Excavation and concrete fit every line. A foundation job moves dirt on the first day, pours days later after the inspection, and has a truckload of concrete and steel delivered in between.

A milestone payment schedule that matches the quote

Pick milestones a customer can see from the driveway: the hole is dug, the footings are poured, the walls are stripped, the backfill is done. A milestone the customer can confirm with their own eyes is a draw that is easy to approve.

Write the schedule into the quote and tie each payment to the lines it covers. California's home improvement contract statute requires, when there are progress payments, a Schedule of Progress Payments in which each payment is stated in dollars and cents and names the work and materials it covers, with the statement that it is against the law for a contractor to collect payment for work not yet completed, or for materials not yet delivered. That is a sound rule everywhere: the draw for the pour comes after the pour.

A four-stage schedule for a foundation job, each draw tied to lines on the quote.
StageDue whenCovers
DepositThe quote is approvedYour state's cap on the contract price
First drawThe hole is dug and inspectedThe excavation and hauling lines
Second drawThe footings and walls are pouredThe concrete, rebar and forming lines
FinalBackfill and cleanup are doneWhat is left, less what has been paid

Bill change orders with the draw that follows the work; one that waits for the final invoice is the one that gets argued about.

An excavator digs a foundation hole on a residential lot
The first draw comes due when the hole is dug and inspected, a milestone the customer can confirm by looking at it.

Contractor deposit limits by state: California and Maryland

The deposit is the stage states regulate most closely. California Business and Professions Code section 7159 applies to home improvement contracts over $500 and requires the contract to state, in at least 12-point boldface, that the down payment may not exceed $1,000 or 10 percent of the contract price, whichever is less. On a $30,000 foundation job that is $1,000.

Maryland's cap is looser. Under its home improvement law (Business Regulation Article, title 8, section 617), a person may not receive a deposit of more than one third of the contract price before or at the time the contract is signed. The same $30,000 job could carry a $10,000 deposit there, and the section lists no exception for custom-ordered materials.

Both caps apply to home improvement work for the owner of the home; a commercial job follows the contract and the state's prompt payment law instead. How much deposit a contractor should ask for walks through more states.

Good to know: This is general information, not legal advice. Statutes change and the details depend on the state and the kind of property; read the current text and ask your licensing board or a construction lawyer before you rely on it.

Lien waivers in plain words

A mechanics lien is the claim a contractor, subcontractor, laborer or material supplier can record against the property when they are not paid. California's licensing board tells homeowners how to protect themselves from one: pay with joint checks, get a signed conditional release from each possible claimant before paying, and an unconditional release from each one paid.

So expect to sign a release at every draw. The two kinds do different jobs:

  • A conditional release takes effect only when the payment clears. California's statutory form for a progress payment opens with a notice that it is effective on receipt of payment and that a person should not rely on it unless satisfied the claimant has been paid.
  • An unconditional release says you have been paid and waive the lien for that work. Sign it after the money is in the bank, never for a check that has not cleared.
  • Each release covers work through a date, with exceptions on the California form for retentions, unpaid extras and earlier progress payments not yet received. Fill those in.

The same statute says a waiver signed to get a progress payment that is not paid in exchange is void unless it substantially follows the statutory form. The trade of release for payment is the whole mechanism; keep the two on the same day.

The preliminary notice is the other half. California requires it from subcontractors and suppliers, not the direct contractor; it can be delivered before work begins and up to 20 days after, and payment is required only for work done 20 days before the notice and afterward, so a sub or supplier who serves it late has given up the early work.

A finished foundation hole with cut earth walls and a level bottom
A release signed for the excavation draw covers work through the date on the form, not the pour that comes next.

Progress billing for contractors: writing the draw invoice

A draw invoice has one job: let the customer, or their lender, approve it without a phone call. It carries:

  • The quote number and the contract price.
  • The stage name from the schedule and the quote lines it covers, at the quote's amounts.
  • What was done and when, with a photo of the milestone if the customer was not on site.
  • A running total: contract price, billed before this invoice, this invoice, and what remains.
  • The payment terms, the ways to pay, and a line saying the lien release follows when the payment clears.

Bill the day the milestone is reached. New York's prompt payment law for private construction contracts makes the calendar month the billing cycle when the parties agree to nothing else and lets the contractor invoice for interim payments at the end of each cycle; the parties may set a different cycle, and a milestone is the shortest one there is.

In MakeHay the deposit goes on the quote as a Deposit and with Stripe connected the customer pays it by card as they approve (ask for a deposit on a quote). Each draw is an invoice started from scratch for the customer and job site with one line for the stage; the final invoice comes from the approved quote with Create invoice, an online deposit comes off the balance on its own, and the draws are taken off by lowering the lines (bill a job in stages). Card and bank payments run through Stripe (connect Stripe), and the invoice list shows what is unpaid and overdue (track unpaid invoices).

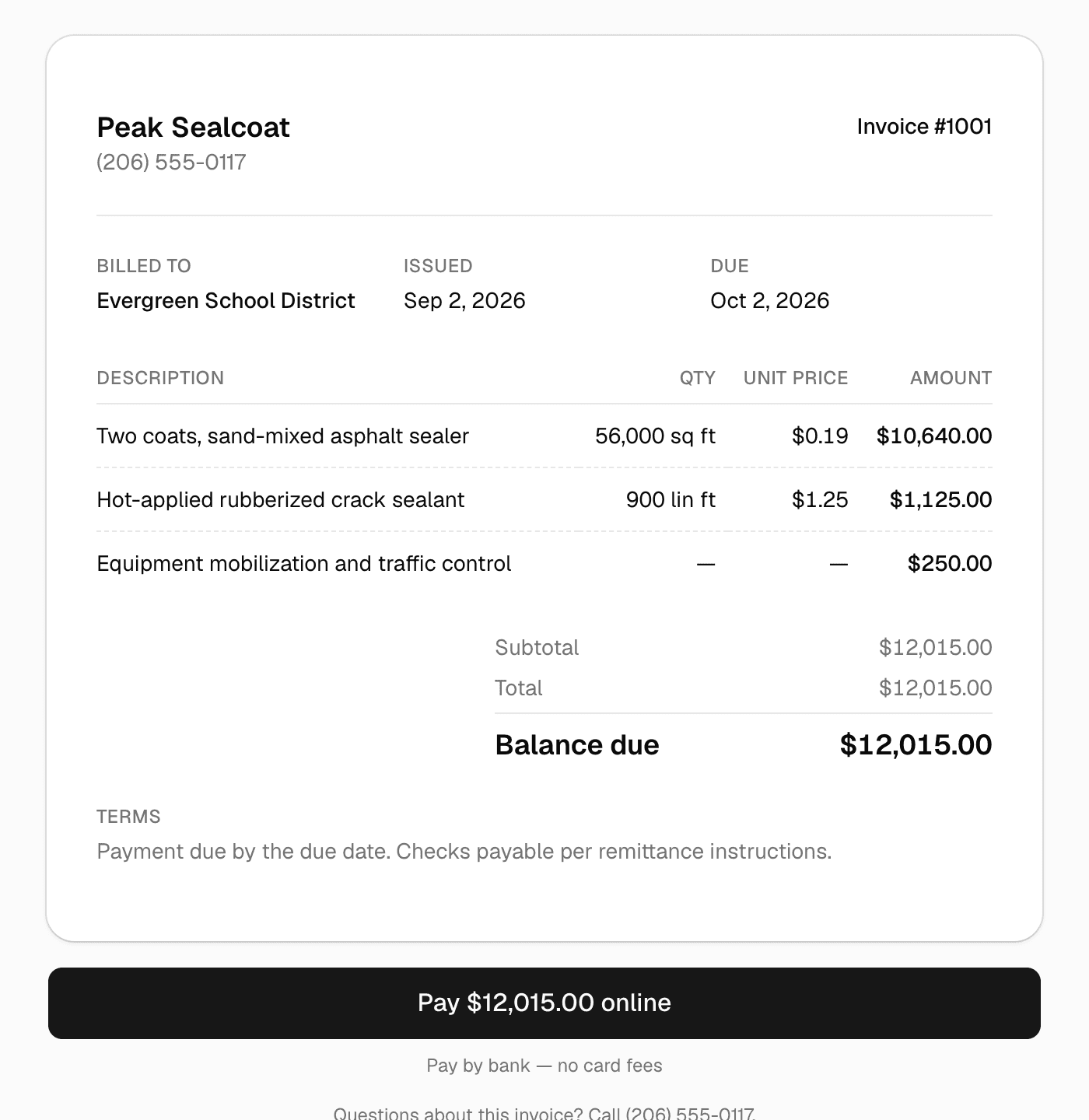

An invoice as the customer sees it, with line items, the balance due and a button to pay

The customer's view of an invoice: the lines it covers, what is due and the button to pay it.

Retainage on commercial work

Retainage is the slice of each draw a commercial owner or general contractor holds back until the job is accepted. The contract decides it unless a statute caps it, and New York does: under General Business Law section 756-c an owner may retain no more than five percent of the contract sum, a contractor no more than five percent from its subcontractors, and the owner must release it within thirty days after final approval of the work, with interest at one percent a month if late. That law covers private construction contracts of $150,000 or more and leaves out one, two and three family homes.

Price it in. Five percent of every draw held for the length of the job is a loan to the owner; carry it in your margin, and invoice the retainage as its own line, with its release date, when acceptance comes through.

When a draw is late

A late draw is a cash problem the same week, so the response is written into the contract before the job starts and followed the day the due date passes.

  1. Step 1: The day after the due date, send the invoice again and ask whether anything on it is disputed. New York gives a private owner twelve business days to approve or disapprove an invoice and thirty days after approval to pay; Texas gives an owner thirty-five days from receiving a payment request.
  2. Step 2: If part is disputed, bill the rest. Texas lets an owner withhold no more than 110 percent of the disputed difference on a detached single-family house, duplex, triplex or quadruplex and no more than 100 percent of it on other property.
  3. Step 3: Charge the interest the statute or the contract allows. Texas sets one and a half percent each month from the day after the due date; New York sets one percent a month, or the contract's higher rate.
  4. Step 4: Give written notice before you stop work. New York requires it at least ten calendar days before a contractor suspends performance over a late payment. A contract clause that says the same works in any state.
  5. Step 5: Protect the lien. The release signed for the last draw was conditional on a payment that never came, so it is not in force; the deadlines for notice and recording run from the dates on the job.

Make paying easy so that lateness is rarely a choice. Nacha says a payment on the ACH Network can be processed in a matter of hours on the same business day, the network settles four times a day, and the Same Day ACH per-payment limit is $1 million, so a draw paid by bank can arrive the same business day. The SBA's finance guide suggests accepting checks only from well-known or in-state banks; a pay link skips the question.

FAQ

How many stages should a job have?

One for the deposit, one for each milestone the customer can confirm by looking, and one final. For a foundation that is usually deposit, excavation, pour and final. More stages than visible milestones means invoices for nothing the customer can see, and those are the ones that wait.

Can a contractor bill for materials before they are delivered?

In California, not beyond the down payment: the home improvement contract must state that collecting payment for materials not yet delivered is against the law, and the down payment is capped at $1,000 or 10 percent of the price, whichever is less. Elsewhere the contract governs; a deposit sized to the order, with the supplier's invoice attached to the draw, is the usual way to cover a special order.

What is the difference between a conditional and an unconditional lien release?

A conditional release waives the lien only once the payment it names has been received; California's form says a person should not rely on it unless satisfied the claimant has been paid. An unconditional release waives the lien outright, so it is signed after the money clears.

Does retainage apply to residential jobs?

Usually not by statute. New York's prompt payment law, which caps retainage at five percent, covers private construction contracts of $150,000 or more and excludes individual one, two and three family dwellings. On a homeowner's job the contract decides, and the final invoice is the hold-back.
